The SEQ Development Brief

Special Edition · 30 July 2026
Curated by
Swish Development

Modular and the money

Factory-built housing finally has money behind it: a big-four bank paying factory invoices, three states writing prefab into their housing programs, and a national certification scheme on the way. This special edition follows the money through a modular deal, from deposit to drawdown to what happens if the factory fails, and sets out how developers and financiers can use the method’s speed without wearing its risks.

The numbers

The special in six figures. Each is verified to the primary source named in the claims ledger.

Pre-fixing drawdown cap (CBA, assessed manufacturer)
80%
vs 60% other manufacturers; capped at 150% of land equity
Modular contract paid before delivery
75–90%
a conventional builder has collected about 40% by frame stage
ilke customers with escrowed deposits recovered
98%
unsecured creditors in the same collapse received nil
Build-time compression, modular vs conventional
up to 50%
McKinsey 2019, reaffirmed August 2025
Prefabricated share of Australian construction
under 5%
Productivity Commission, February 2025
Lawful prefab deposit in Queensland
20%
vs 5% standard; the warranty scheme excludes off-site prefab work
Why now

Less than 5% of Australian construction is prefabricated, on the figure the Productivity Commission cited in February 2025. Every government in the country has decided that number should rise.

Since early 2025 the money and the rules have followed, and each step removed a specific financing barrier:

The Australian Building Codes Board is building the national manufacturer certification scheme now; prefabAUS reports Queensland will participate, with delivery expected in 2028.

None of this guarantees modular wins. It does mean the finance question has moved from “no” to “on what terms”, and the terms are worth understanding before your competitors do.

The promise: weeks and dollars

The case for building in a factory is time.

McKinsey’s 2019 study, still the most-cited evidence in the field, found modular projects completed 20 to 50% faster than conventional builds; its August 2025 follow-up stands by “up to 50 percent” while conceding the sector has seen an above-average number of failures. The Australian versions are more concrete: prefabAUS puts a factory build at 10 to 12 weeks against 18-plus months conventional, and the Queensland government says on-site time can be three months against a year.

Speed converts to money in four places:

The arithmetic is easy to run on your own numbers. Carry $1.5M of debt at 9% for six months less and you keep roughly $67,000, before prelims, rates and insurance. That is our arithmetic, not a study result, and it is the right shape of calculation for any modular feasibility.

Now the counterweights:

Modular pays you in time and charges you in flexibility. Projects that cannot use the time (no holding debt, no presale pressure, no season risk) have little reason to pay the premium.

The payment curve problem

Here is the tension the whole issue hangs on. A conventional Queensland build is paid in arrears, against work fixed to your land:

Traditional stage (QBCC schedule) Payment Cumulative
Deposit 5% 5%
Base 15% 20%
Frame 20% 40%
Enclosed 25% 65%
Fixing 20% 85%
Practical completion 15% 100%

A modular contract inverts that. Anchor Homes, a Victorian manufacturer on CBA’s assessed list, publishes its schedule; it sits at the heavier end of an industry that front-loads 75 to 90% of the price before delivery:

Modular stage (Anchor Homes) Payment Cumulative
Deposit 5% 5%
Frame 20% 25%
Lock-up 25% 50%
Fixing 40% 90%
Handover 10% 100%

The frame, lock-up and fixing stages happen in a factory, over eight to ten weeks. Swanbuild’s published terms run the same direction, wanting roughly two-thirds to three-quarters before the home leaves the factory. By the time a modular home reaches your land you have paid for most of it; a conventional builder would have collected about a quarter by the same point on the calendar.

Queensland law adds a twist most people miss:

Commercial developers contract outside Schedule 1B and negotiate the curve freely, which is where the structures below come in.

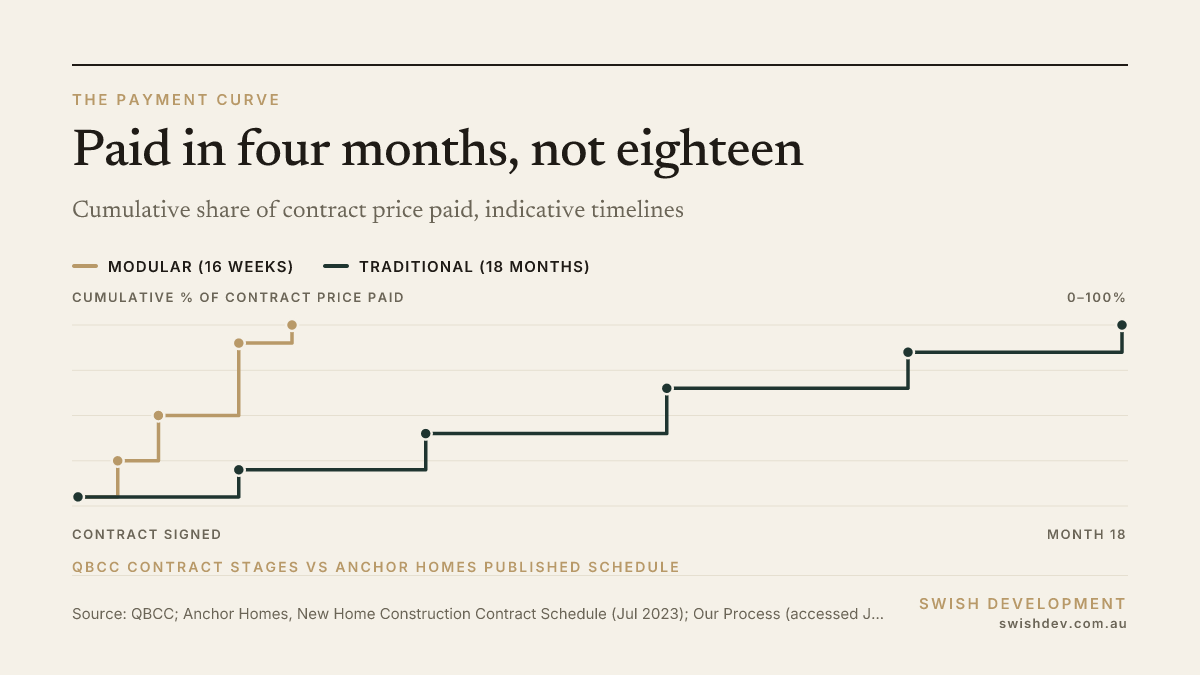

Chart of the week Chart of the week

Payment curves: modular vs traditional

The whole finance problem in one picture: traditional stage claims crawl to 100% over a year or more against work on your land; a modular schedule (shown: Anchor Homes’ published terms, timelines indicative) reaches 90% around installation, inside four months. The money moves earlier, but the exposure window is a third the length. Whether that trade works depends on what the money is exposed to while the home sits in a factory.

Why lenders say no

A construction loan is secured by a mortgage over land and everything fixed to it. A module on a factory floor 200km away is not fixed to anything. It is personal property, not real property, and the lender’s mortgage gives it no claim over it.

CBA says this in writing, in its own prefab factsheet: “the land will be used as the sole security up until the prefab home is transported to site”, and if the builder fails before fixing, “this may result in negative equity and you will still be required to repay the construction home loan”. That is a bank that lends on modular telling you exactly what it is exposed to. Banks that have not made that choice simply decline.

The law is settled and unforgiving:

An unfixed module sits outside the standard mortgage machinery on both sides of the world: the security does not attach and the valuation does not count it.

How deals are getting done

The deadlock is breaking from three directions at once.

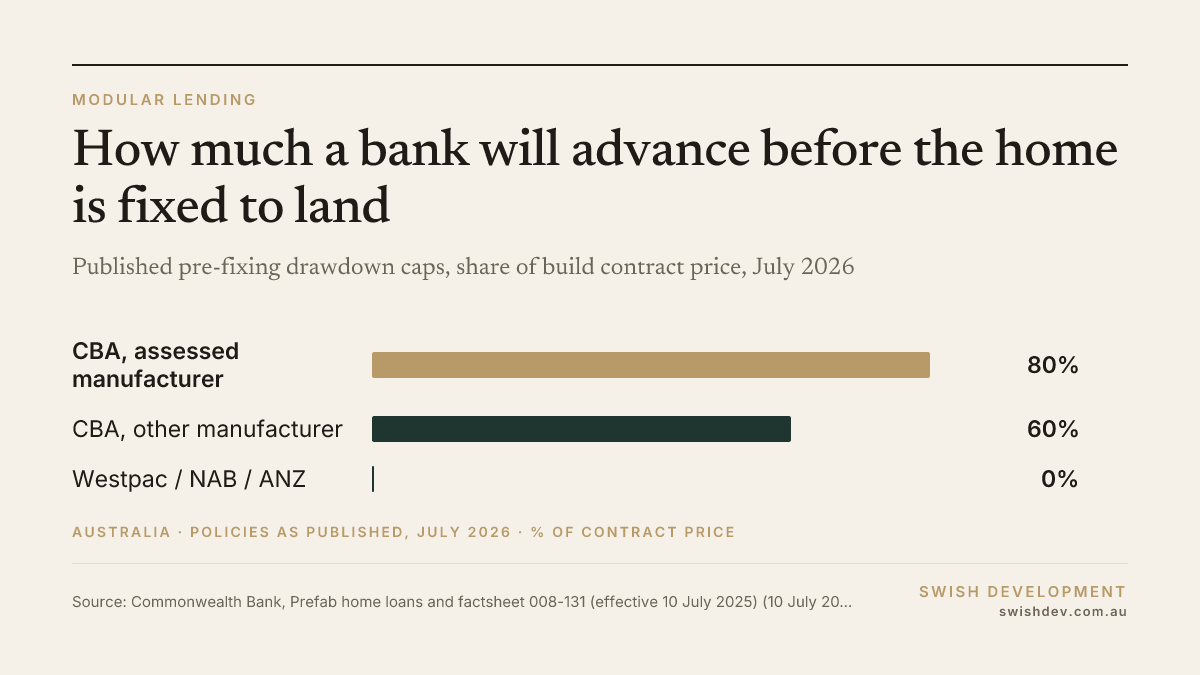

The bank route

CBA’s policy, effective 10 July 2025, is the template to study even if you bank elsewhere:

Term Assessed manufacturer Other manufacturer
Pre-fixing drawdowns Up to 80% of contract price Up to 60%
Land equity ceiling 150% of land value less land debt 120%
Contract Fixed-price, up to $1.5M Fixed-price, up to $1.5M
Completion test Fixed to land, connected to services Same

Two design choices matter:

How deals are getting done

Pre-fixing drawdown caps by lender

As of July 2026 no other major bank group has published an equivalent. Westpac told reporters in September 2025 it had no planned changes; NAB was “considering”; ANZ declined to comment. Bankwest (CBA-owned) has added a modular progress payment in WA, and Keystart runs the most generous scheme in the country: around 2% deposit, eight approved builders, a flat $400 a month during the build. The gap between CBA’s terms and everyone else’s silence will not last; be positioned for the second mover.

The contract route

For developers outside the consumer framework, the protective instruments are old, cheap and proven. The UK collapses supplied the evidence of which ones work:

Instrument What it does Evidence it matters
Escrowed advance payments Deposits sit in a ring-fenced account, released against milestones ilke Homes customers recovered 98% through escrow; unsecured creditors got nothing
Advance payment and off-site materials bonds A surety repays if the manufacturer fails before delivery Aviva bonds paid out on Caledonian Modular contracts
Vesting deed Title to identified, insured, segregated modules passes as you pay Standard UK practice; what lenders certify against
PPSR registration Perfects your interest so modules do not vest in the insolvent estate The Forge Group lesson
Step-in rights You can take over the manufacturing contract on insolvency UK practice guidance since 2020
Assessed manufacturer Someone with audit access has checked the factory’s finances CBA’s roster doubles as free due diligence

None of these is exotic. A vesting deed plus a PPSR registration costs a fraction of one per cent of contract value. The ilke evidence below prices the difference at roughly the whole deposit.

The manufacturer route

We looked hard for manufacturers financing projects themselves. It exists at the edges, not the middle:

When it goes wrong: the UK file

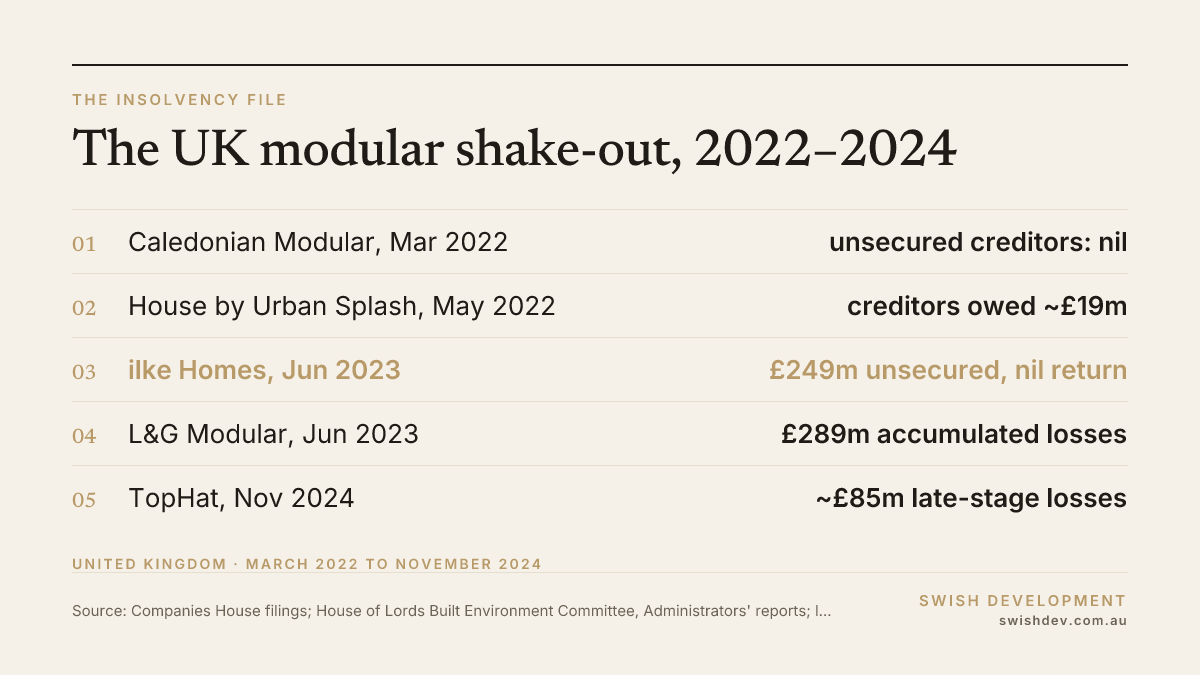

Between March 2022 and November 2024 the UK lost essentially its entire flagship modular sector: Caledonian Modular, House by Urban Splash, ilke Homes, L&G Modular, Modulous and TopHat.

This matters to an Australian reader for one reason: the administrators’ reports are a complete, public record of who lost money, who did not, and why. The UK paid the tuition. The lessons are free.

When it goes wrong: the UK file

The UK modular shake-out, 2022 to 2024

The mechanism was the same each time:

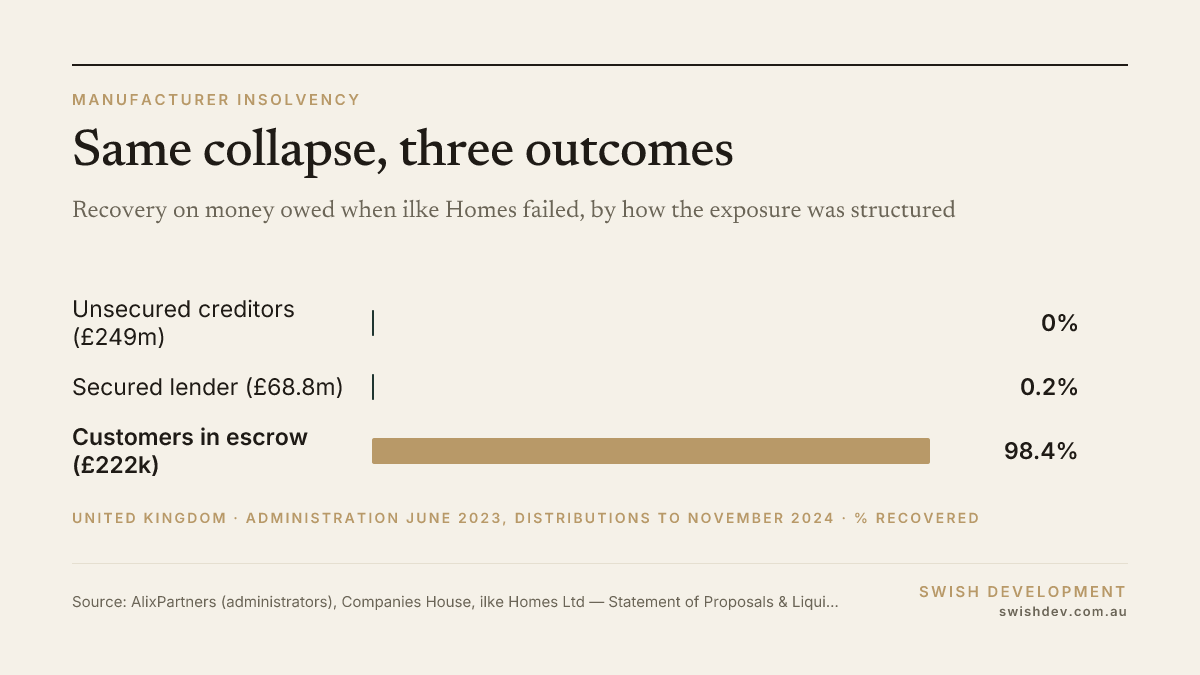

Inside the ilke administration, outcomes split three ways. This is the most useful finance lesson in the issue:

Same collapse, same week, three outcomes, decided entirely by deal structure.

When it goes wrong: the UK file

Same collapse, three outcomes: ilke Homes recovery rates

The modules themselves taught a second lesson. ilke held around 360 finished and part-finished modules at collapse. They proved nearly worthless: bespoke to customers’ sites, tangled in supplier title claims, their certification manuals locked in a software system the administrators could not access because the bills were unpaid. The entire stock, plus the company’s IP, sold for £125,000. Whoever holds title to a part-built module in an insolvency holds much less than they think.

Two Australian footnotes:

The lesson Australia gets for free

The comparison that matters is not Australia against the UK’s failure; it is Australia against the countries where factory housing quietly works.

Country What makes it financeable Where it stands
Japan Manufacturers integrate finance, land and after-care; decades of steady demand Sekisui House: 2.7M+ homes built cumulatively
Sweden State-anchored demand since the Million Homes Programme built lasting capacity Industry reports ~80% of houses use factory-built elements
UK Lender assurance existed (BOPAS, 2013) but demand was a soft ambition Flagship factories collapsed 2022–2024
NZ Westpac NZ built the first dedicated prefab mortgage (2019) Product survives; scale modest
Australia Bank accreditation, government factories and orders, certification by 2028 Under construction now

The pattern is plain: modular scales where demand is steady and the financier can trust the manufacturer, and fails where factories are built on hope.

Australia is running a different order of operations from the UK, and it is the right one:

What to expect from here, on the pattern: the ABCB scheme lands around 2028 and gives every lender a national accreditation to hang policy on; a second bank moves before then; valuers get standing instructions for certified prefab; progress-payment reform spreads from NSW. Each step is the Australian version of something that already worked somewhere else.

The remaining risk is the one no scheme removes: individual manufacturers will still fail. That is why the contract toolkit is not optional.

The playbook

For developers

For financiers

The through-line of this issue is unusually clean. Modular’s finance problem is real, precisely locatable, and being dismantled piece by piece, with the expensive experiments already run offshore and documented in administrators’ reports. The developers who learn the structures early get a faster build, a shorter exposure window and a funding market that is finally turning up. We would rather be early to that than late.

Key insights

Modular trades duration risk for counterparty risk.

A conventional build exposes you to eighteen months of market, weather and builder risk while your cash goes out slowly. Modular compresses that to about four months but asks for most of the money while the home is still someone else’s chattel in someone else’s shed. Price both sides in the feaso.

Paperwork decides who survives a collapse.

The ilke estate returned 98 cents in the pound to escrowed customers and zero to everyone else. Escrow, vesting deeds, PPSR registration and bonds are cheap relative to a 20% deposit; treat them as the cost of admission.

Queensland’s deposit rules cut both ways.

The 20% prefab deposit allowance makes modular contracts workable for manufacturers, but the warranty scheme excludes off-site prefabrication, so the bigger deposit rides uncovered until the work is on site. Lead with an escrowed deposit as a point of difference.

Land equity is the new gearing lever.

CBA caps pre-fixing drawdowns at 150% of land value less land debt. That quietly rewards land-rich, low-geared projects with the most factory-stage funding, the reverse of how developers usually think about gearing a site.

Factories die of order famine, not bad product.

Every UK collapse traces to fixed costs meeting a lumpy order book. The safest Australian counterparties are the ones with government or bank-assessed order books, which is exactly what QBuild’s pipeline and CBA’s roster now provide.

Australia is sequencing this correctly.

The UK built factories first and the trust infrastructure never caught up. Australia is building the trust infrastructure first: bank accreditation now, prescribed progress payments in NSW, national certification by 2028, with governments as anchor customers rather than shareholders. That is why the positive read is the evidence-based one.

Watchlist
Commonwealth Bank: only major bank group with published pre-fixing prefab lending as at July 2026; 12 assessed manufacturers, policy effective 10 July 2025.
Westpac, NAB and ANZ: no equivalent published policy; Westpac said in September 2025 it had no planned changes. The first mover among them changes the market.
Oly Homes: CBA-funded Sunshine Coast factory stepping from 200 to about 550 homes a year, due to complete in late 2026.
QBuild: state-owned modular factories at Eagle Farm, Zillmere and Cairns, up to 600 modular homes committed.
Modscape: the country’s largest offsite plant at Essendon Fields, about 2,000 modules a year capacity.
On our radar
Late 2026: Oly Homes’ 21,900sqm Sunshine Coast factory scheduled to complete.
2027-28: remaining federal prefab allocations flow to the states (2026-27 Budget Paper No. 3 lists state splits as not yet determined).
2028: ABCB national manufacturer certification expected (per prefabAUS); a second major bank moving before that date is the signal to watch.
